Shipping Fire Alarm Cables from China to Saudi Arabia

Ningbo, China → Jeddah, Saudi Arabia

Customer Background

The customer is a construction materials and low-voltage systems supplier based in Jeddah, Saudi Arabia. They supply fire detection and alarm systems to electrical contractors working on commercial and residential projects across the western region, importing the cabling and accessories from Chinese manufacturers.

This order covered fire alarm cables for a group of hotel projects under construction in the Jeddah and Makkah corridor. The cables had to meet Saudi fire-safety product requirements, which made the shipment more than a routine cable import — certification status had to be correct before the goods left the factory.

Cargo Information

Item Detail
Commodity Fire alarm cables (fire-resistant low-voltage signal cables, on drums and in coils)
Container type 1 × 40HQ (Full Container Load)
Origin Ningbo, China
Destination Jeddah, Saudi Arabia
Incoterm FOB Ningbo
Gross weight Approx. 18,200 kg
Volume Approx. 48 CBM

The cargo consisted of fire alarm cables in multiple gauge sizes, supplied on wooden drums and in cardboard coils. Cables are dense, heavy cargo — a 40HQ of cable typically runs 17–19 metric tons, which is near the container's payload limit. The shipment was made up of drums at the container floor with coils stacked above.

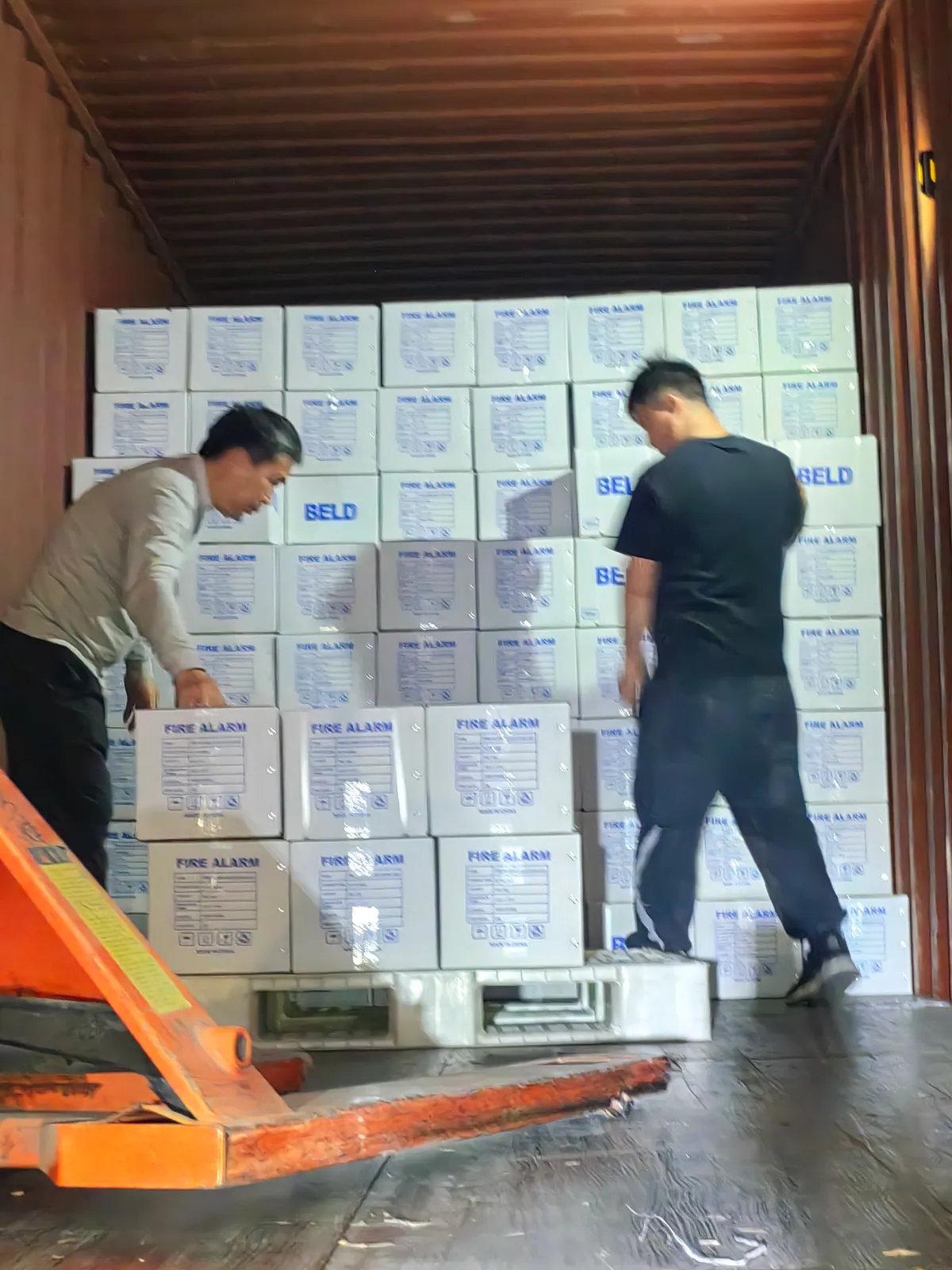

Fig 1: Fire alarm cable drums and coils inside the 40HQ at the port in Ningbo — drums floor-loaded, coils stacked above

Why This Shipping Method

Sea freight in a 40HQ was the only practical option for this cargo. Cable is heavy, high-volume, and non-urgent — there was no commercial case for air freight, which would have been cost-prohibitive at this weight. The 40HQ was selected because the ~48 CBM of cable with drums would not fit a 20GP, and the weight (~18.2 t) sits within the 40HQ payload envelope.

The route from Ningbo to Jeddah typically uses a direct or single-transshipment service. In this case the booking used a direct service calling Jeddah Islamic Port, avoiding the added handling and transit time of a transshipment for a heavy container.

Shipping Process

Step 1 — Supplier confirmation of certification status

Before booking was confirmed, the manufacturer's SABER (Saudi Product Safety Programme) certification status for the cable was verified. Fire alarm cable is a regulated product category under the Saudi quality mark system, and the factory had an existing product certificate (PC). The batch shipment required a shipment certificate (SC) to be issued against that PC before the goods could clear import customs in Jeddah.

Step 2 — Cargo collection and container loading

The drums and coils were collected from the factory in the Ningbo area and loaded into the 40HQ at the terminal. Loading was arranged floor-to-roof with the drums laid on their sides at the floor and secured with timber wedges to prevent rolling during transit. The coils were stacked above the drum layer. Loading was completed in one day.

Step 3 — Export customs clearance

Export customs clearance was handled in Ningbo. Fire alarm cable is not restricted for export from China, and the declaration — commercial invoice, packing list, and certificate of origin — was submitted and cleared without issue.

Step 4 — SABER shipment certificate (SC) application

In parallel with the export process, the shipment certificate was applied for against the factory's product certificate. The application was submitted with the commercial invoice, packing list, and the PC reference, and the SC was issued and sent to the customer's broker in Jeddah before the vessel arrived. This front-loading of the certificate was the critical step for avoiding a customs hold at destination.

Step 5 — Ocean freight and destination clearance

The vessel sailed from Ningbo to Jeddah Islamic Port with a transit time of approximately 18 days. On arrival, the container was cleared through Saudi customs using the pre-issued SC, and the cable was delivered to the customer's warehouse in Jeddah.

Challenges Encountered

1. SABER certification timing

Fire alarm cable is a regulated category under Saudi's SABER programme. The shipment could not clear import customs without a valid product certificate (PC) on file and a shipment certificate (SC) for the specific batch. If the SC was not issued before the vessel arrived, the container would sit at Jeddah port accruing demurrage until the certificate was processed.

2. Heavy-weight container handling

At roughly 18.2 tons, the container was operating near the 40HQ payload limit. Cables on drums are prone to shifting during transit if not properly secured, which creates a safety risk in addition to cargo damage risk. The drum-to-coil loading pattern needed to be planned for stability, not just volume.

How We Solved Them

For the SABER certification timing:

The certification check was moved to the front of the process, before booking. The factory's existing PC was verified as valid for the cable specification being shipped, and the SC application was prepared in parallel with the export documentation. The SC was issued and sent to the customer's Jeddah broker several days before the vessel's estimated arrival, so the import declaration could be lodged immediately on arrival with no waiting period. This eliminated the demurrage risk entirely.

For the heavy container handling:

The drums were loaded on their sides at the container floor and wedged with timber to prevent rolling. The coils were stacked above the drum layer in interlocked rows. Weight was distributed evenly across the container floor to keep the container's centre of gravity low and stable. The container was weighed at the port to confirm it was within the payload limit before sealing.

Final Timeline

Milestone Date
Certification status verified June 9
Cargo collected from factory, Ningbo June 11
Container loading completed June 12
Export customs clearance June 13
SC application submitted June 13
Vessel departure from Ningbo June 15
Arrival Jeddah Islamic Port July 3
Saudi customs clearance completed July 4
Delivery to customer warehouse, Jeddah July 5

Total door-to-door transit time: 26 days

Final Cost

The total cost for this shipment was approximately $4,150, broken down as follows:

  • Ocean freight (Ningbo → Jeddah, 1×40HQ): ~$2,480
  • Inland trucking and loading (Ningbo): ~$360
  • Export customs clearance: ~$150
  • SABER shipment certificate (SC) and verification: ~$180
  • Destination customs clearance and broker fees (Jeddah): ~$480
  • Terminal handling charges (Jeddah): ~$240
  • Delivery to warehouse in Jeddah: ~$260

The customer paid the ocean freight, inland trucking, and export-side charges to DTFU Logistics; destination-side charges and certification fees were settled through their local broker.

Ocean freight rates on the Ningbo–Jeddah route fluctuate with season and vessel utilization. The figures above reflect the rate at the time of booking (June 2026).

Customer Review

"The cable was a regulated product and the certificate was the part we were worried about. The shipment certificate was issued before the vessel even arrived, so customs was cleared on the first day. The cable arrived in good condition, and the weight was within what we expected for a 40HQ."

— The customer's procurement manager, Jeddah

Lessons Learned

  • For regulated products, certification work starts before booking, not at the port. Fire alarm cable under Saudi SABER needs a valid PC on file and an SC for the batch. Verifying the PC before confirming the booking removes the biggest risk of a demurrage hold at Jeddah.

  • Front-load the SC to the destination broker. Issuing the shipment certificate before vessel arrival and sending it to the broker in advance means import clearance can be lodged the moment the vessel docks. The SC fee (~$180) is trivial compared to the cost of even a few days of demurrage.

  • Heavy cable containers need a stability plan, not just volume planning. Drums on the floor with timber wedges and coils stacked above, with even weight distribution, keeps an 18-ton container stable in transit. This is a loading-standard decision made at the warehouse, not on the dock.

  • Cable at ~18 tons is near payload. A 40HQ of cable runs close to the weight limit even when it is only about half full by volume. Confirm the weight before booking, because the volume can look half-empty while the container is at its weight ceiling.

Ready to Write Your Own Success Story?

Whether you ship 8 containers a month or 80, our team will design a solution that saves you money and eliminates headaches.

Get a Custom Quote for Your Shipment

Fill out the form below and our team will get back to you within 2 hours during business hours.

Chat with us on WhatsApp
